Monday, 22 December 2014

Habberley Learning Village, Early Years Hub - Week 31

Activity/Observations
 Internal MF partitions + boarding + skim now advanced
 Floor vinyl, to rooms requiring fixed furniture follow on
 Install kitchenette units + fixed furniture
 Electrical 2nd fix
 Mechanical 2nd fix, fan coil heaters, etc.
 Plumber 1st fix
 Mist coat and 1st coat painting
 Ceiling grids + lighting
 Carpentry 2nd fix – doors, linings, skirting, architraves,
 IPS, vanity units and proprietary cubicle partitions
 CIS data cabling
 Slab on edge external plinth
 Paving, steps ramps, etc. west of building/campus square - Further drainage around the building
 Mono blocks, campus square around 60% complete
 Shutter and pour concrete bases to canopy, throughout route

The foundations for the covered route to the Early Years Hub as it approaches St. John's Primary

Outside areas beside the EYH

Progress on the classroom areas

Wyre Forest School -Week 76

Activity/Observation
 M & E works are continuing.
 Finishes to wall boarding and ceilings are continuing.
 Fitting of vertical slabs to the perimeter of the floor slab is almost complete.
 Single ply roof covering and flashings almost complete.
 Fitting of cedar fascias, barge boards and window cheeks are almost complete.
 Decorations are continuing.
 Tiles to ceiling being fitted.
 Wall tiling is continuing, including tiling to hydro pool.
 Sanitary items being fitted.
 Plumbing panels are continuing, basin and hinged rail fixings to address.
 Gutter fixing is to complete.
 2nd fix Carpentry is continuing.
 Storm water drainage connections from down pipe positions continuing.
 Face brickwork to retaining walls are almost complete.
 Laying of vinyl floor covering is progressing to various areas, including laying of liquid D.P.M.
 Furniture fitting is to complete.
 General external works continuing.
 Lift installation to both areas are almost complete.

Work on the eastern (primary) outdoor areas

Outside the main entrance - preparing for the base for the canopy

Western outdoor areas - secondary games courts

Hoist track over the hydrotherapy pool


Progress on the main foyer

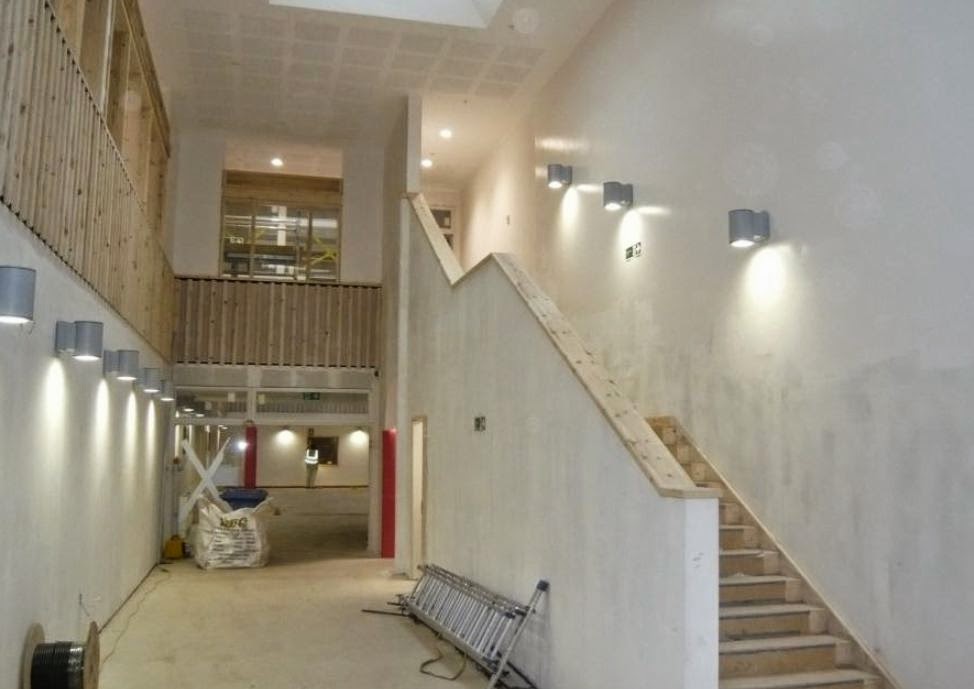

Stair 3 and lift up to Campus Square

Key Stage 4 Classroom with glazed group room

Monday, 15 December 2014

Early Years Hub - Progress Photos Week 30



Wyre Forest School- week 94

Activity/Observation
 M & E works are continuing.
 Finishes to wall boarding and ceilings are continuing.
 Acoustic separating floor system repairs and replacing of areas to complete.
 Fitting of vertical slabs to the perimeter of the floor slab is almost complete.
 Single ply roof covering and flashings almost complete.
 Fitting of cedar fascia's, barge boards and window cheeks are almost complete.
 Decorations are continuing.
 Metal framed bulkheads, ceilings and suspended ceiling grids being erected.
 Wall tiling is continuing, including tiling to hydro pool.
 Sanitary items being fitted.
 Plumbing panels are continuing, basin and hinged rail fixings to address.
 Works within Atrium is progressing.
 Gutter fixing is to complete.
 2nd fix Carpentry is continuing.
 Storm water drainage connections from down pipe positions continuing.
 Face brickwork to retaining walls are progressing.
 Laying of vinyl floor covering is progressing to various areas, including laying of liquid D.P.M.
 Furniture fitting is continuing.
 General external works continuing.
 Lift installation to both areas are continuing.
Dining Hall with ceiling tiles installed

Catering kitchen units being installed

Floor tiles are laid in the hydrotherapy pool hall

Bathroom Management Area

Floor being prepared in the Atrium

Progress on the outdoor areas

Tuesday, 9 December 2014

Wyre Forest School - week 74

Activity/Observation M & E works are continuing.
 Finishes to wall boarding and ceilings are continuing.
 Acoustic separating floor system to complete.
 Fitting of vertical slabs to the perimeter of the floor slab is almost complete.
 Single ply roof covering and flashings almost complete.
 Fitting of cedar fascia's, barge boards and window cheeks are almost complete.
 Decorations are continuing.
 M.F. bulkheads, ceilings and suspended ceiling grids being erected.
 Wall tiling is continuing, including tiling to hydro pool.
 Soil and vent and sink waste pipes being fitted.
 Plumbing panels are continuing.
 Works within Atrium is progressing.
 Gutter fixing is to complete.
 2nd fix Carpentry is continuing.
 Storm water drainage connections from down pipe positions continuing.
 Face brickwork to retaining walls are progressing.
 Laying of vinyl floor covering is progressing to various areas, including laying of liquid D.P.M.
 Sports hall floor is in progress.
 Furniture fitting is continuing.
 General external works started.
 Lift installation to both areas are continuing.
 Fitting of climbing frames almost complete.


So what's next?
 Continue external works, roof covering flashings, internal wall boarding,decorations and acoustic floor, 2nd fix Carpentry, M & E works, wall tiling, ceilings, floor covering.



Progress on a Key Stage 4 first floor classroom

Lighting being installed in the assembly hall

Primary classbase

Sports Hall with basketball nets installed

Units installed in the food tech room


Hydrotherapy pool with wall and floor tiling

School office with view of main entrance

Progress on the outdoor areas to the west of the school

Retaining wall to Primary hard play


Foyer


Monday, 8 December 2014

Early Years Hub - Week 29

View from Campus Square

Open plan nursery area

Reception class area

The curved entrance lobby

The main entrance
Activity/Observations
 Internal Metal framed partitions + boarding + skim now advanced
 Floor vinyl, commencing west of building
 Install kitchenette units
 Electrical 2nd fix
 Mechanical 2nd fix, fan coil heaters, etc.
 Plumber 1st fix
 Mist coat and 1st coat painting
 Ceiling grids
 Carpentry 2nd fix - linings, skirting, architraves
 Toilet plumbing, vanity units and proprietary cubicle partitions
 Data networks
 Cedar soffits
 Slab on edge external plinth
 Paving, steps ramps, etc. west of building/campus square - Further drainage around the building
 Tarmac, upper campus square
 Reduce levels to canopy, commencing adjacent existing school


Wednesday, 3 December 2014

Wyre Forest School - Week 73

'Cell web' reinforcement is laid so the tarmac to teh minibus compound can be laid under the trees without damaging the roots.

The top course of bricks is laid on the retaining wall. The bricklayers are coping well.

Progress in the Hydrotherapy Pool

Sheet flooring being laid in classrooms

In stair 3, a test fitting of the ballustrade ahead of powder coating.
Activity/Observation
 M & E works are continuing.
 Finishes to wall boarding and ceilings are continuing.
 Acoustic separating floor system repairs and replacing of areas to complete.
 Fitting of vertical slabs to the perimeter of the floor slab is continuing.
 Single ply roof covering and flashings almost complete.
 Fitting of cedar fascia's, barge boards and window cheeks are almost complete.
 Decorations are continuing.
 bulkheads, ceilings and suspended ceiling grids being erected.
 Wall tiling is continuing, including tiling to hydro pool.
 S.V.P.s and sink waste pipes being fitted.
 Plumbing panels are continuing, basin and hinged rail fixings to address.
 Works within Atrium is in progress.
 Gutter fixing is to complete.
 2nd fix Carpentry is continuing.
 Storm water drainage connections from down pipe positions continuing.
 Decking to enclosed external terraced areas to complete.
 Face brickwork to retaining walls are progressing.
 Laying of vinyl floor covering is progressing to various areas, including laying of liquid D.P.M.
 Sports hall floor is in progress.
 Furniture fitting is continuing.
 General external works started.
 Lift installation to both areas are continuing.

So what's next?
 Continue external works, roof covering flashings, internal wall boarding, decorations and acoustic floor, 2nd fix Carpentry, M & E works, wall tiling, ceilings, furniture fitting, floor covering.

Monday, 1 December 2014

Early Years Hub - Week 28

Activity/Observations
 Internal Metal framed partitions + boarding + skim
 Floor vinyl, commencing west of building
 Install kitchenette units
 Electrical 2nd fix
 Mechanical 2nd fix, fan coil heaters, etc.
 Plumber 1st fix
 Mist coat painting
 Ceiling grids
 Carpentry 2nd fix – linings, skirting, architraves
 IPS, vanity units and proprietary cubicle partitions
 CIS
 Cedar soffits
 Retainer block walls, paving, steps ramps, etc. west of building/campus square - Further drainage around the building
 Prep ahead of insulation and slab on edge external plinth






Monday, 24 November 2014

Wyre Forest School -Week 72

Activity/Observation
 M & E works are continuing.
 Finishes to wall boarding and ceilings are continuing.
 Acoustic separating floor system repairs and replacing of areas to complete.
 Fitting of vertical slabs to the perimeter of the floor slab is continuing.
 Single ply roof covering and flashings almost complete.
 Fitting of cedar fascia's, barge boards and window cheeks are almost complete.
 Decorations are continuing.
 M.F. bulkheads, ceilings and suspended ceiling grids being erected.
 Wall tiling is continuing, including tiling to hydro pool.
 S.V.P.s and sink waste pipes being fitted.
 Plumbing panels are continuing, basin and hinged rail fixings to address.
 Works within Atrium is in progress.
 Gutter fixing is to complete.
 2nd fix Carpentry is continuing.
 Storm water drainage connections from down pipe positions continuing.
 Decking to enclosed external terraced areas to complete.
 Face brickwork to retaining walls are progressing.
 Laying of vinyl floor covering is progressing to various areas, including laying of liquid D.P.M.
 Sports hall floor is in progress.
 Furniture fitting is continuing.
 General external works started.
 Lift installation to both areas in progress.

So what's next?
 Continue external works, roof covering flashings, internal wall boarding, decorations and acoustic floor, 2nd fix Carpentry, M & E works, wall tiling, ceilings, furniture fitting, floor covering.

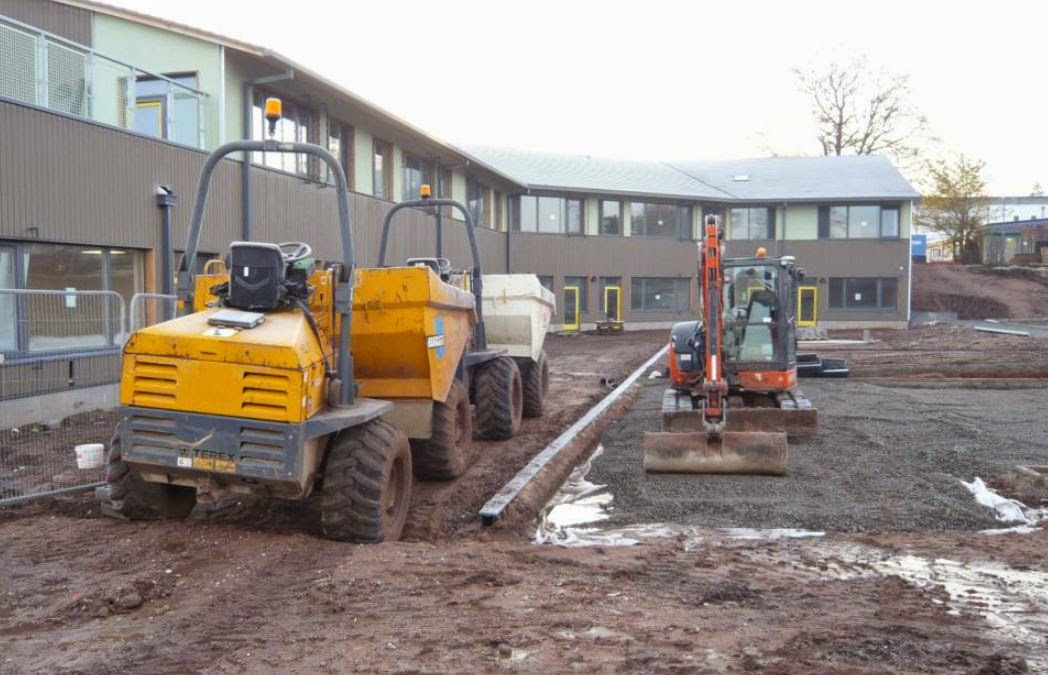

Progress on KS3/4 outdoor area

Retaining wall by the Primary outdoor area

Pool hall with pool cover installed

Primary classroom with practical area

Ceiling installation in the dining area


Lift doors installed


Tuesday, 18 November 2014

Vocational Hub - November 2014

Progress:

Partitions are almost complete
First fix mechanical pipework and electrical
Under floor services being installed
Whiterock hygenic wallcovering to the Food Technology room
Battening and resilient bars for ceilings

What's next

Prepare floors
Install plasterboard ceilings, mist coat decoration
Prepare for fitted furniture
Continued M&E works




Food tech rom with under floor services to island units
Service trench in the food technology room

Preparing to install the ceiling in the ICT area

Food Tech room servery looking towards the cafe
